Texas PS-48 Pipeline Construction Signals: Source-Backed Project Watchlist
Texas PS-48 pipeline construction signals with source rows, reported miles, operator concentration, county concentration, timing windows, T-4 status, and caveats.
By Johnathan · Reviewed by EnergyNetWatch Research · Last updated 2026-06-25
Recurring watchlist
This page is part of the recurring EnergyNetWatch signal library. Durable watchlist pages are refreshed as source records change.
Key Takeaways
- PS-48 records can show operator, project, product type, diameter, mileage, counties, stated construction start, and T-4 availability when present.
- The record does not prove contract award, spend, in-service status, exact route geometry, or current field progress.
- The useful workflow is ranking the rows, then checking T-4, route, facility, interconnect, plant, meter station, compressor station, and nearby activity context.
Texas PS-48 records add a construction-stage layer to Texas pipeline research.
The T-4 permit record is still important. It helps identify pipeline authority, system context, and route evidence when GIS or detail records are available.
PS-48 is different. It can show construction notices before a public review has enough route, facility, interconnect, or field-progress evidence to call the project complete.
That makes PS-48 useful for a specific question:
Which Texas pipeline construction records are specific enough to check now?
Current Public Snapshot

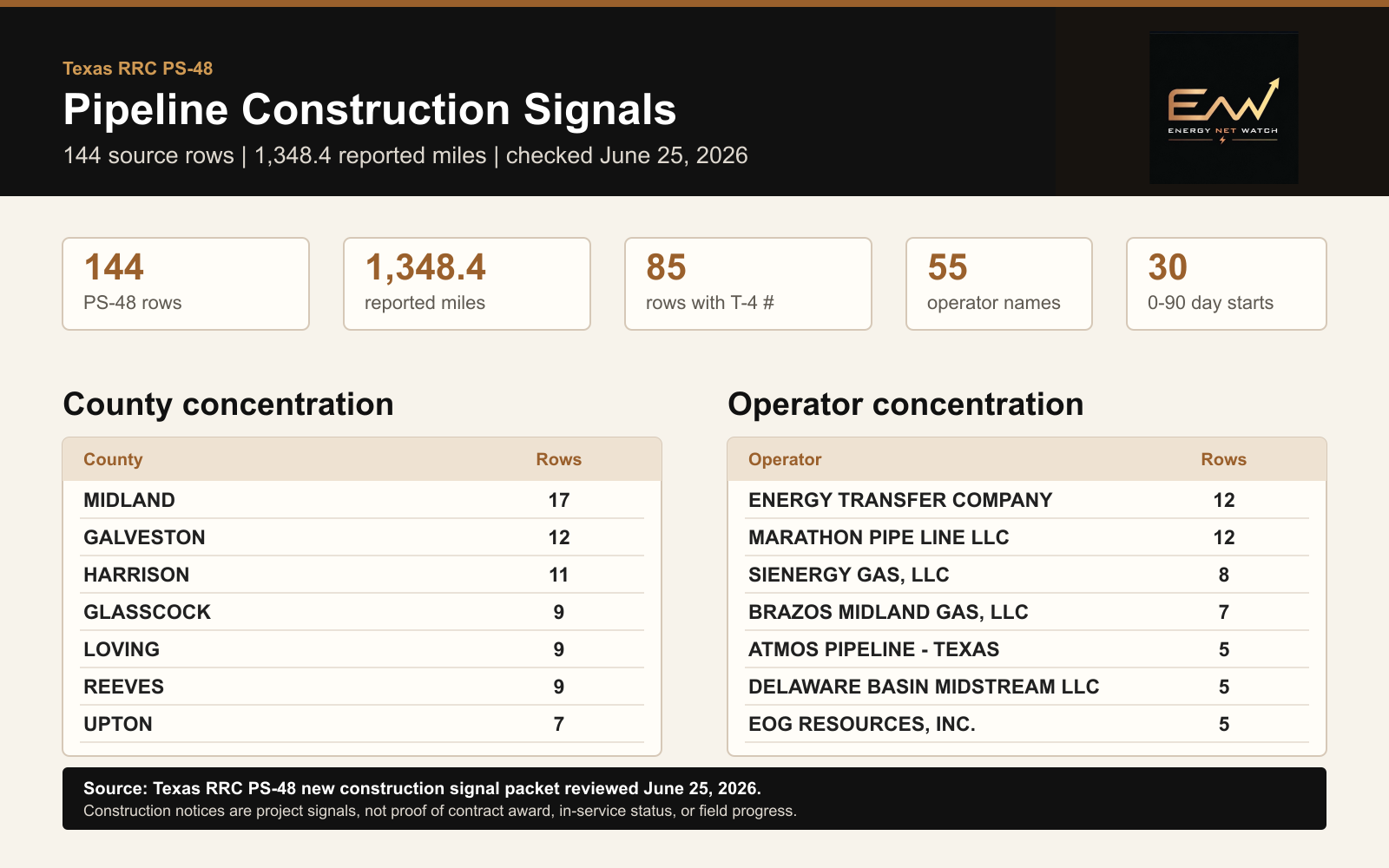

EnergyNetWatch reviewed the current Texas RRC PS-48 new construction signal packet on June 25, 2026.
| Metric | Current signal |
|---|---|
| PS-48 source rows | 144 |
| Reported miles | 1,348.4 |
| Unique operator names | 55 |
| Rows with T-4 numbers | 85 |
| Starts inside 90 days | 30 |
| Natural gas gathering rows | 73 |
| Natural gas transmission rows | 31 |
| Hazardous liquid transmission rows | 22 |

This is not a completion list.
It is a construction-notice review. The value is in separating project names, counties, timing windows, T-4 availability, product type, mileage, and follow-up checks.
What PS-48 Records Can Show
| Source field | Why it matters |
|---|---|
| Operator name | Gives the first account or system label to check. |
| Project or system name | Can point to a lateral, expansion, corridor, customer tie-in, or named line. |
| Product type | Separates gathering, transmission, distribution, and liquids work. |
| Diameter | Helps separate small local work from larger corridor or capacity signals. |
| Reported mileage | Shows whether the record is a short lateral, county-level buildout, or multi-county corridor. |
| County list | Turns the record into a territory and nearby-activity check. |
| Stated construction start | Creates a timing window, but still needs current-status review. |
| T-4 number when present | Gives a route/system handle for deeper RRC and GIS review. |
What The Record Does Not Prove
| Not proven | Why not |
|---|---|
| Contract award | PS-48 does not identify vendor awards. |
| Spend or project value | Mileage and diameter are not CAPEX. |
| In-service status | A construction notice is not an operation record. |
| Exact route geometry | Route evidence needs T-4/GIS/detail review. |
| Field progress | The start date may be stale or revised. |
| Full commercial relationship | The record may not identify every producer, shipper, facility, or counterparty. |
That caveat is the point. A useful public record does not have to prove everything. It has to tell the user what to check next.
How EnergyNetWatch Turns PS-48 Into A Workflow
EnergyNetWatch uses the PS-48 row as the starting point, then organizes the follow-up:
| Step | EnergyNetWatch layer |
|---|---|
| 1 | Rank construction signals by timing, size, T-4 status, and source specificity. |
| 2 | Group records by operator, project name, county, product type, mileage, and diameter. |
| 3 | Separate started, 0-30 day, 31-60 day, 61-90 day, and later timing windows. |
| 4 | Check T-4, GIS, route, plant, interconnect, meter station, compressor station, and nearby activity context. |
| 5 | Build a review list for sales, business development, service, fabrication, automation, measurement, and midstream teams. |
The public page shows the shape of the workflow. The app workspace carries the exact rows, current source dates, filters, exports, alerts, and API-ready fields.
Current Signal Examples
| Rank | Operator | Project | Product | Reported miles | Timing |
|---|---|---|---|---|---|
| 1 | Energy Transfer Company | Hugh Brinson 42in | Natural gas transmission | 325.0 | Started / validate status |
| 2 | WWM Operating, LLC | DBR Expansion | Natural gas transmission | 53.5 | 0-30 days |
| 3 | WWM Operating, LLC | Chevron Power Lateral | Natural gas transmission | 22.2 | 0-30 days |
| 4 | WWM Operating, LLC | Traverse Pipeline | Natural gas transmission | 152.1 | Started / validate status |
| 5 | Buffalo Run Pipeline LLC | LGD-C Blending To Pembrook | Natural gas transmission | 30.0 | 61-90 days |
These rows are public proof points, not final account claims.
For example, a 42-inch transmission row across multiple counties deserves a different review than a short lateral. A row with a T-4 number deserves a route/system check. A row without a T-4 number may still matter, but the follow-up starts with the project name, operator label, counties, product type, and source document.
County Concentration
The current packet points to a broad Texas infrastructure review, but several counties appear more often than others.
| County | PS-48 mentions |
|---|---|
| Midland | 17 |
| Galveston | 12 |
| Harrison | 11 |
| Glasscock | 9 |
| Loving | 9 |
| Reeves | 9 |
| Upton | 7 |
| Martin | 5 |
| Pecos | 5 |
| Reagan | 5 |
County concentration matters because the same source row can be checked against nearby wells, permits, production, facilities, plants, interconnects, and route evidence.
Operator Concentration
| Operator | PS-48 rows |
|---|---|
| Energy Transfer Company | 12 |
| Marathon Pipe Line LLC | 12 |
| SiEnergy Gas, LLC | 8 |
| Brazos Midland Gas, LLC | 7 |
| Atmos Pipeline - Texas | 5 |
| Delaware Basin Midstream LLC | 5 |
| EOG Resources, Inc. | 5 |
| Sabine Oil & Gas Corporation | 5 |
The count is only the starting point. A five-row operator with near-term starts, large diameter, or strong county concentration may deserve more attention than a larger operator with older or lower-specificity records.
Who Might Use This
Service teams can use the timing window and county list to decide which projects are worth checking before outreach.
Measurement, automation, controls, and SCADA teams can look for larger transmission, gathering, tie-in, and blending records that need deeper route and facility review.
Fabrication and construction-support teams can use mileage, diameter, product type, and county spread to decide which rows deserve a project file.
Midstream teams can use the same record to check route evidence, interconnect context, and nearby upstream activity.
Analysts can use the caveats to avoid overstating what a construction notice proves.
Request the current Texas PS-48 project signal report, companion CSV, and app workspace.
Frequently Asked Questions
What is a Texas PS-48 record?
In this workflow, PS-48 refers to Texas RRC new pipeline construction notice records used to identify construction-stage pipeline signals. EnergyNetWatch reviews those records as source rows, then organizes project, operator, county, product, timing, and T-4 context.
Is PS-48 the same as T-4?
No. T-4 is the pipeline permit/system route layer EnergyNetWatch checks when a T-4 number or route evidence is available. PS-48 is useful because it can add construction-stage context before every route or field-progress question is resolved.
Does a PS-48 row prove construction is active?
No. It creates a record to check. The stated start date, T-4 status, route evidence, facility context, and current source status still need review.
Why publish this publicly?
Because the public row is only part of the value. The useful work is turning the row into a ranked project signal with caveats, timing windows, related records, and a clean follow-up path.
Sources
Data notes
EnergyNetWatch reviewed the current Texas RRC PS-48 new construction signal packet and companion project-signal CSV on June 25, 2026. Counts are based on 144 source rows in the reviewed packet. Reported mileage, timing windows, T-4 status, operator counts, and county mentions are source-derived review fields, not claims of spend, contract award, in-service status, exact route geometry, or field progress.
